UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 1 of 13 R-1 Line #222
Exhibit R-2, RDT&E Budget Item Justification: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319: Research, Development, Test & Evaluation, Navy / BA 7: Operational
Systems Development
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
COST ($ in Millions)
Prior
Years FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total FY 2022 FY 2023 FY 2024 FY 2025
Cost To
Complete
Total
Cost
Total Program Element
323.162 66.934 72.265 110.349 - 110.349 121.877 130.793 117.884 116.583 Continuing Continuing
0366: MK 48 ADCAP
323.162 66.934 72.265 110.349 - 110.349 121.877 130.793 117.884 116.583 Continuing Continuing
A. Mission Description and Budget Item Justification
MK-48 ADCAP (Advanced Capability) Research, Development, Test and Evaluation (RDT&E) program executes incremental development of weapon performance
improvements in two development product areas: (1) Advanced Processor Builds (APBs), and (2) Torpedo Technology Insertions (TIs). This Program Element
(0205632N/0366) is tied to development programs that leverage a joint United States/Australia Armaments Cooperative Project (ACP) to develop MK-48 ADCAP
CBASS; technologies developed by the Office of Naval Research (ONR), and the Office of the Secretary of Defense (OSD) Strategic Capabilities Office (SCO).
Countermeasure (CM) sophistication and availability on the open market directly affects ADCAP kill proficiency and its ability to counter rapidly evolving threats. The
focus of the MK-48 ADCAP Torpedo Research and Development (R&D) program is on hardware upgrades, rapid Commercial-Off-the-Shelf (COTS) insertion, and
software APBs, in order to rapidly upgrade the ADCAP to counter evolving threats and maintain robust performance. The CBASS program developed and fielded a new
sonar capable of identifying CMs and discriminating them from the target. CBASS Phase I achieved IOC in FY 2006. CBASS Phase II achieved IOC in FY13 . APB5
conducted an early fielding decision in May 2019.
The Royal Australian Navy (RAN) is jointly participating to develop MK48 ADCAP upgrades and signed a Memorandum of Agreement (MOA) extension amendment in
January 2019, which extends the MOA for fifteen (15) years.
The MK-48 ADCAP Torpedo R&D program focuses on two specific areas near term; Torpedo software APBs and hardware Tech Insertions (TIs). The CNO continues
to stress shallow water as a critical operating area to counter third world diesel electric submarines and near-peer adversaries. In water testing, in conjunction with
laboratory simulation efforts, has shown that significant performance improvements can be made by implementing changes to weapon tactics and software algorithms.
Development, implementation, and testing of these changes are being accomplished under the Torpedo APB (TAPB) program. The TAPB program also leverages the
RAN joint torpedo program and technologies developed by ONR and SCO in the areas of torpedo broadband signal processing, tactics processing, and alertment.
The TI program will provide for evolutionary torpedo hardware improvements and upgrades, including the transition and testing of advanced technologies from the R&D
community. This approach will incorporate developmental testing of the transitioning technologies from ONR, and SCO for ADCAP upgrades in the areas of torpedo
sensors, weapon propulsion, weapon/platform connectivity, and improved fusing. These efforts will continue torpedo development investment at a lower cost and
shorter term than traditional torpedo programs.
The MK 48 MOD 7 APB6/TI-1 Heavyweight Torpedo (HWT) program is an evolutionary upgrade to the MK 48 MOD 7 HWT; it will consist of an Operational Software
(OPSW) upgrade referred to as APB 6 and a hardware upgrade referred to as TI-1. TI-1 will include a Guidance and Control (G&C) section upgrade, and an Improved
Post Launch Communications System (IPLCS). TI-1 will also include features from three ONR Future Naval Capabilities (FNC) programs.
Volume 5 - 545
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 2 of 13 R-1 Line #222
Exhibit R-2, RDT&E Budget Item Justification: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319: Research, Development, Test & Evaluation, Navy / BA 7: Operational
Systems Development
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
The APB7/TI-2 HWT program is an evolutionary improvement to the MK 48 MOD 7 HWT, providing extended range and advanced multi-mission capabilities against
surface and sub-surface targets. It will consist of an Operational Software (OPSW) upgrade referred to as APB7 and a hardware upgrade referred to as TI-2. APB7/TI-2
includes sensing, processing, warhead and propulsion technologies developed under SCO and ONR FNC research and development programs. APB6/TI-1 and APB7/
TI-2 provide two distinctly different capabilities and are operationally intended for different mission sets.
APB5 software upgrades achieved early fielding in May 2019, and are currently in operational testing for MK-48 ADCAP torpedoes to field the full capability in FY20.
APB5+ software upgrades are currently in process for MK-48 ADCAP torpedoes. APB5+ enhancements are required to address Combat Control System (CCS)/MK48
pre and post launch interface issues which limit crew full implementation of the weapon and provide numerous capability enhancements requested and endorsed by the
Fleet.
ONR and SCO technologies and MK-54 LWT developments will be transitioned into ADCAP through APBs and TI packages.
B. Program Change Summary ($ in Millions)
FY 2019 FY 2020 FY 2021 Base FY 2021 OCO FY 2021 Total
Previous President's Budget 68.255 85.973 108.520 - 108.520
Current President's Budget 66.934 72.265 110.349 - 110.349
Total Adjustments -1.321 -13.708 1.829 - 1.829
• Congressional General Reductions - -
• Congressional Directed Reductions - -13.708
• Congressional Rescissions - -
• Congressional Adds - -
• Congressional Directed Transfers - -
• Reprogrammings - -
• SBIR/STTR Transfer -1.321 0.000
• Rate/Misc Adjustments 0.000 0.000 1.829 - 1.829
Change Summary Explanation
FY2021: Increased budget request is due to additional funds being provided to transition hardware development and testing from the OSD Strategic Capabilities
Office (SCO)into TI-2. Furthermore, funds continue to support APB 6 software development and TI-1 Hardware development contract and Hardware support. As
APB 5 completes testing, support funding shifts from APB 5 to APB 5+ and APB 6 software support. The FY2021 increase in Test & Evaluation funds are due to
the increased number of test events to support the APB 5+, APB 6/TI-1, and APB7/TI-2.
Volume 5 - 546
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 3 of 13 R-1 Line #222
Exhibit R-2A, RDT&E Project Justification: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
COST ($ in Millions)
Prior
Years FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total FY 2022 FY 2023 FY 2024 FY 2025
Cost To
Complete
Total
Cost
0366: MK 48 ADCAP
323.162 66.934 72.265 110.349 - 110.349 121.877 130.793 117.884 116.583 Continuing Continuing
Quantity of RDT&E Articles - - - - - - - - -
A. Mission Description and Budget Item Justification
MK-48 ADCAP RDT&E program executes incremental development of weapon performance improvements in two development product areas: (1) APBs, and (2)
Torpedo Technology Insertion. The budget enables development to address CNO defined capability-based requirements and mission needs. This Program Element
(0205632N/0366) is tied to development programs that leverage a joint United States/Australia ACP to develop MK-48 ADCAP; and technologies being developed by
the ONR and SCO. APB Software upgrades will improve torpedo performance in challenging water and countered environments. Hardware technology insertions will
improve weapon availability through development of a G&C replacement, new warhead, propulsion, and an Automated Test Equipment replacement.
B. Accomplishments/Planned Programs ($ in Millions, Article Quantities in Each)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Title: TORPEDO APB / TEST & EVLUATION
Articles:
FY 2020 Plans:

Continue APB 6 Software development.
Continue TI-1 Hardware development.
Conduct TI-1 System Functional Review (SFR).
Conduct APB 6/TI-1 Preliminary Design Review (PDR).

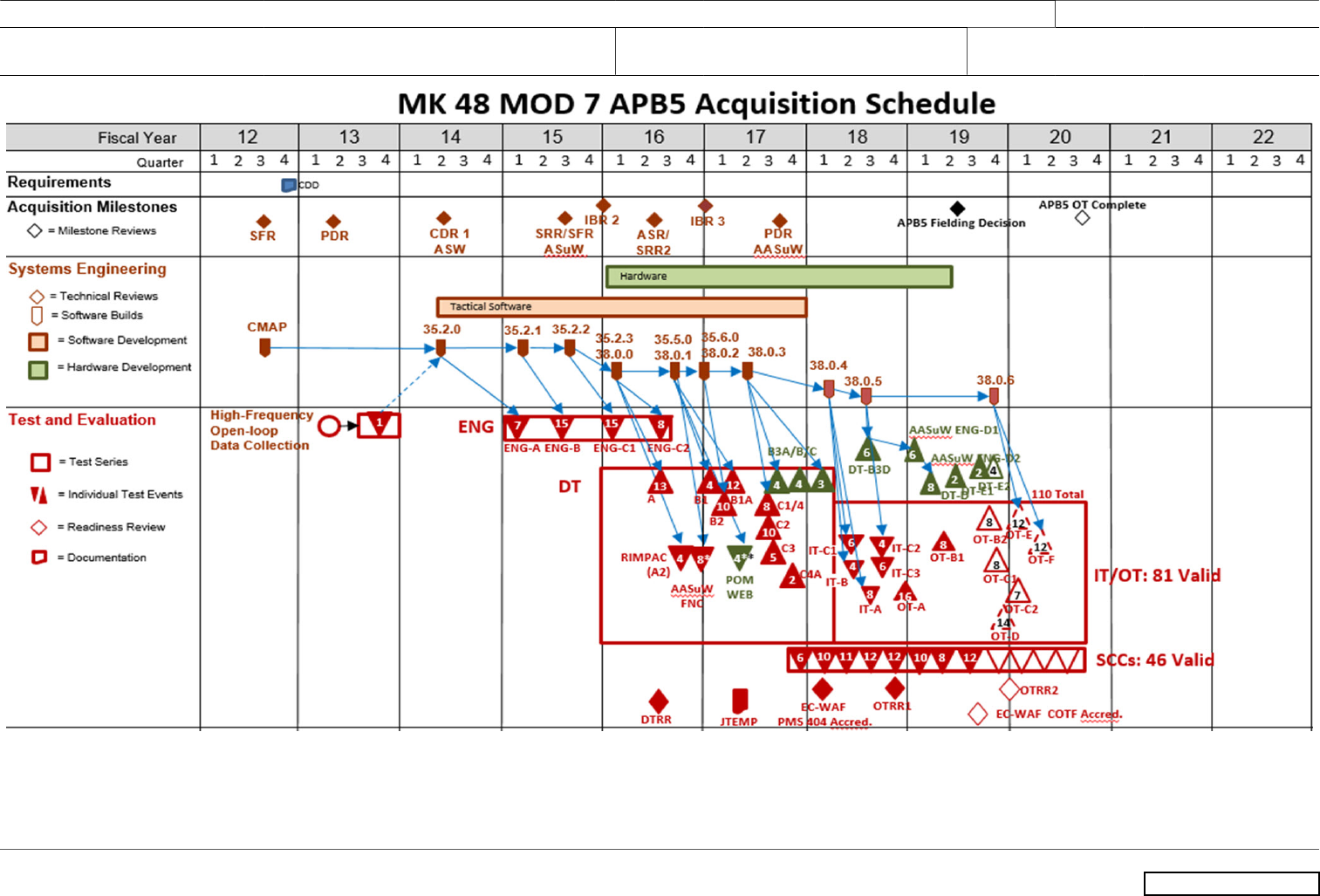

APB5 - Complete Operational Testing (OT).
APB5 - Complete Initial Operational Capability (IOC).
APB5+ - Conduct CDR.
APB5+ - Conduct DTRR.
APB5+ - Conduct Development Test (DT) in-water testing.

FY 2021 Base Plans:
Continue APB6 Software development.
Continue TI-1 Hardware development.
Continue APB6 Modeling & Simulation development.
APB6 - Conduct CDR
TI-1 - Conduct CDR
APB5+ - Conduct OTRR
APB5+ - Begin Operational Testing (OT)
APB5+ - Conduct Modeling & Simulation testing.
66.934
-
72.265
-
110.349
-
0.000
-
110.349
-
Volume 5 - 547
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 4 of 13 R-1 Line #222
Exhibit R-2A, RDT&E Project Justification: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
B. Accomplishments/Planned Programs ($ in Millions, Article Quantities in Each)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
APB5+ - Complete Operational Testing (OT).
APB5+ - Complete Initial Operational Capability (IOC).

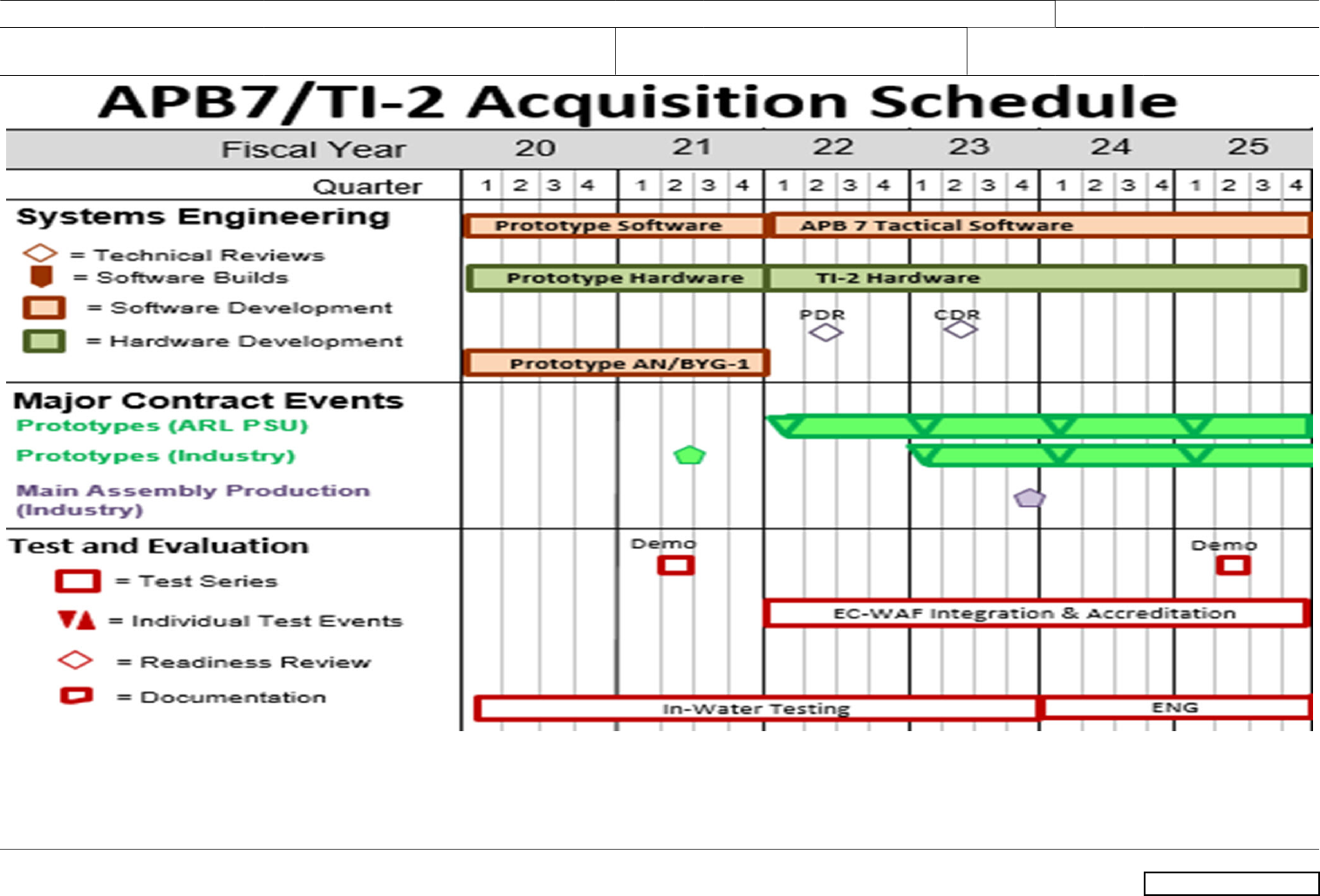

APB7 - software prototype development and builds.
Prototype combat system software development.
APB7/TI-2 - Modeling and Simulation.
APB7/TI-2 - In-water Test Events and Prototype Demonstration.
FY 2021 OCO Plans:
N/A
FY 2020 to FY 2021 Increase/Decrease Statement:
FY21 increase is due to the funding requirement needed to transition TI-2 hardware development from the OSD
Strategic Capabilities Office (SCO) and conduct rapid prototype demonstration.
Accomplishments/Planned Programs Subtotals
66.934 72.265 110.349 0.000 110.349
C. Other Program Funding Summary ($ in Millions)
Line Item FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total FY 2022 FY 2023 FY 2024 FY 2025
Cost To
Complete Total Cost
• WPN/3225: MK-48
Torpedo ADCAP Mods
39.997 39.508 56.454 - 56.454 36.328 20.573 59.876 61.073 0.000 1,538.609
• WPN/3117: MK-48 Torpedo 103.616 114.000 284.355 - 284.355 146.855 153.040 198.103 236.702 Continuing Continuing
Remarks
D. Acquisition Strategy
In FY 2016, a competitive contract was awarded to procure additional warshot torpedos and continue procurement of CBASS Kits. The Program will continue to execute
competitive, build to print contracts, until inventory requirements are met and all Mod 6 torpedos are converted. Throughout the contract the program will execute life of
type buys to minimize the impact of obsolescence avoiding redesign and qualification during a contract cycle. The next competitive contract is planned for FY 2021 and
will include fuel tank and warhead electronic sections.
Continue to incrementally develop technology to pace the threats to be integrated into the production baseline. A competitive contract for TI-1 hardware development
was awarded in FY 2019. The development contract includes a LRIP options to procure kits to be used for OT and a new competitive FRP contract will be awarded in
FY26. This hardware will be used to upgrade the entire inventory.
Volume 5 - 548
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 5 of 13 R-1 Line #222
Exhibit R-2A, RDT&E Project Justification: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
The APB7/TI-2 acquisition strategy is to fund the Penn State University Applied Research Laboratory to complete prototype builds and testing from the OSD SCO
program and implement design refinements for industry builds. Competitive industry manufacturing contract awards are planned starting in FY23 for developmental and
operational test units.
Volume 5 - 549
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 6 of 13 R-1 Line #222
Exhibit R-3, RDT&E Project Cost Analysis: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Product Development ($ in Millions)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost Category Item
Contract
Method
& Type
Performing
Activity & Location
Prior
Years Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Cost To
Complete
Total
Cost
Target
Value of
Contract
Software Development -
APB 5 / 5+
WR
NUWC NPT :
Newport RI
38.959 9.057 Oct 2018 2.594 Nov 2019 2.248 Nov 2020 - 2.248 Continuing Continuing Continuing
Software Development -
APB 6
WR
NUWC NPT :
Newport RI
18.448 16.774 Oct 2018 17.799 Nov 2019 19.623 Nov 2020 - 19.623 Continuing Continuing Continuing
Hardware Development -
TI-1
WR
NUWC NPT :
Newport RI
21.415 5.798 Oct 2018 4.163 Nov 2019 1.984 Nov 2020 - 1.984 Continuing Continuing Continuing
Hardware Development -
TI-1
C/CPIF
Progeny : Manassas,
VA
0.000 5.071 Mar 2019 27.545 Dec 2019 38.166 Jan 2021 - 38.166 Continuing Continuing Continuing
Hardware Development -
IPLCS
C/CPFF
Harris Corp. :
Melbourne, FL
0.087 5.462 Oct 2018 5.462 Nov 2019 8.010 Nov 2020 - 8.010 Continuing Continuing Continuing
Hardware Development -
IM
WR
Indian Head : Indian
Head, MD
1.636 0.450 Jan 2019 0.450 Nov 2019 0.450 Oct 2020 - 0.450 Continuing Continuing Continuing
Software Development -
APB 7
WR
NUWC NPT :
Newport RI
0.000 0.000 0.000 2.140 Dec 2020 - 2.140 0.000 2.140 -
Hardware Development -
Blue Wolf
WR
NUWC NPT :
Newport RI
0.000 5.000 May 2019 0.000 0.000 - 0.000 0.000 5.000 -
Software Development -
Sprial 4 / PY Development
WR
NUWC NPT :
Newport RI
31.839 0.000 0.000 0.000 - 0.000 0.000 31.839 -
Hardware Development -
TI-2
C/CPFF
ARL / PSU : State
College PA
0.000 0.000 0.000 11.394 Nov 2020 - 11.394 0.000 11.394 -
Hardware Development -
TI-2
WR
NUWC NPT :
Newport RI
0.000 0.000 0.000 4.584 Nov 2020 - 4.584 0.000 4.584 -
Hardware Development -
TI-2
WR
NSWC, IH : Indian
Head, MD
0.000 0.000 0.000 1.059 Nov 2020 - 1.059 0.000 1.059 -
Subtotal
112.384 47.612 58.013 89.658 - 89.658 Continuing Continuing N/A
Remarks
- Increased funding in FY21 for TI-1 hardware development.
- Increased funding in FY21 for IPLCS development and Engineering Development Model (EDM) fabrication.
- Increased funding in FY21 for TI-2 hardware prototype demonstration and testing. This includes system engineering, hardware/software prototype design updates, assembly,
and rebuilds in support of in-water testing and demonstration program.
- Decreased funding in FY21 for APB 5/5+ as product development funding shifts to APB 7 and TI-2 development.
Volume 5 - 550
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 7 of 13 R-1 Line #222
Exhibit R-3, RDT&E Project Cost Analysis: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Support ($ in Millions)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost Category Item
Contract
Method
& Type
Performing
Activity & Location
Prior
Years Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Cost To
Complete
Total
Cost
Target
Value of
Contract
Software Development -
APB 5/APB5+
WR
NUWC NPT :
Newport RI
35.143 3.130 Oct 2018 2.200 Oct 2019 2.200 Nov 2020 - 2.200 Continuing Continuing Continuing
Software Development -
APB 6
WR
NUWC NPT :
Newport RI
1.545 1.195 Oct 2018 1.652 Oct 2019 1.661 Nov 2020 - 1.661 Continuing Continuing Continuing
Software Development -
APB 6
WR
NUWC KPT :
Keyport WA
1.622 0.230 Oct 2018 0.435 Oct 2019 0.438 Nov 2020 - 0.438 Continuing Continuing Continuing
Software Development /
PY Development
Various
Various : Not
Specified
36.317 0.000 0.000 0.000 - 0.000 0.000 36.317 -
Integrated Logistics
Support
WR
NUWC NPT :
Newport RI
2.243 0.000 0.000 0.000 - 0.000 0.000 2.243 -
Systems Engineering WCF C/LH
NUWC NPT :
Newport RI
17.750 0.000 0.000 0.000 - 0.000 0.000 17.750 -
Systems Engineering Various
NUWC NPT :
Newport RI
0.676 0.000 0.000 0.000 - 0.000 0.000 0.676 -
Subtotal
95.296 4.555 4.287 4.299 - 4.299 Continuing Continuing N/A
Test and Evaluation ($ in Millions)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost Category Item
Contract
Method
& Type
Performing
Activity & Location
Prior
Years Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Cost To
Complete
Total
Cost
Target
Value of
Contract
Test & Evaluation - APB
5/5+
WR
NUWC NPT :
Newport RI
21.989 5.282 Oct 2018 3.370 Oct 2019 5.838 Oct 2020 - 5.838 Continuing Continuing Continuing
Test & Evaluation - APB
5/5+
WR
NUWC KPT :
Keyport WA
32.007 5.783 Oct 2018 4.160 Oct 2019 2.080 Oct 2020 - 2.080 Continuing Continuing Continuing
Test & Evaluation - APB
5/5+
WR
OPTEVFOR : Norfolk
VA
11.195 1.631 May 2019 0.515 May 2020 0.530 Dec 2020 - 0.530 Continuing Continuing Continuing
Test & Evaluation - APB 6 C/CPFF
ARL / PSU : State
College PA
0.873 1.510 Apr 2019 1.344 Oct 2019 1.589 Nov 2020 - 1.589 Continuing Continuing Continuing
Modeling & Simulation WR
NUWC NPT :
Newport RI
9.745 0.000 0.000 0.000 - 0.000 0.000 9.745 Continuing
Modeling & Simulation C/CPFF
ARL / PSU : State
College PA
14.112 0.000 0.000 0.000 - 0.000 0.000 14.112 Continuing
Volume 5 - 551
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 8 of 13 R-1 Line #222
Exhibit R-3, RDT&E Project Cost Analysis: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Test and Evaluation ($ in Millions)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost Category Item
Contract
Method
& Type
Performing
Activity & Location
Prior
Years Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Cost To
Complete
Total
Cost
Target
Value of
Contract
Test & Evaluation - Spiral
4 / PY
WR
NUWC NPT :
Newport RI
18.376 0.000 0.000 0.000 - 0.000 0.000 18.376 -
Test & Evaluation - TI-2 WR
NUWC KPT :
Keyport WA
0.000 0.000 0.000 5.778 Nov 2020 - 5.778 0.000 5.778 -
Subtotal
108.297 14.206 9.389 15.815 - 15.815 Continuing Continuing N/A
Remarks
- Increased funding in FY21 for APB 5+ test events and post test analysis.
- Increased funding in FY21 for TI-2 hardware prototype in-water testing and range events.
Management Services ($ in Millions)
FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost Category Item
Contract
Method
& Type
Performing
Activity & Location
Prior
Years Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Award
Date Cost
Cost To
Complete
Total
Cost
Target
Value of
Contract
Program Management C/CPFF Serco : Mclean VA 5.836 0.511 Dec 2018 0.526 Dec 2019 0.542 Dec 2020 - 0.542 0.000 7.415 -
Travel WR
NAVSEA :
Washington DC
1.349 0.050 Dec 2018 0.050 Dec 2019 0.035 Dec 2020 - 0.035 0.000 1.484 -
Subtotal
7.185 0.561 0.576 0.577 - 0.577 0.000 8.899 N/A
Prior
Years FY 2019 FY 2020
FY 2021
Base
FY 2021
OCO
FY 2021
Total
Cost To
Complete
Total
Cost
Target
Value of
Contract
Project Cost Totals
323.162 66.934 72.265 110.349 - 110.349 Continuing Continuing N/A
Remarks
Volume 5 - 552
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 9 of 13 R-1 Line #222
Exhibit R-4, RDT&E Schedule Profile: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Volume 5 - 553
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 10 of 13 R-1 Line #222
Exhibit R-4, RDT&E Schedule Profile: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Volume 5 - 554
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 11 of 13 R-1 Line #222
Exhibit R-4, RDT&E Schedule Profile: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Volume 5 - 555
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 12 of 13 R-1 Line #222
Exhibit R-4, RDT&E Schedule Profile: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Volume 5 - 556
UNCLASSIFIED
PE 0205632N: MK-48 ADCAP
UNCLASSIFIED
Navy Page 13 of 13 R-1 Line #222
Exhibit R-4A, RDT&E Schedule Details: PB2021Navy
Date: February 2020
Appropriation/Budget Activity
1319 / 7
R-1 Program Element (Number/Name)
PE 0205632N / MK-48 ADCAP
Project (Number/Name)
0366 / MK 48 ADCAP
Schedule Details
Start End
Events by Sub Project Quarter Year Quarter Year
Proj 0366
APB 5 Development: Early Fielding Decision 3 2019 3 2019
APB 5 Development: APB 5 Operation Test (OT) 4 2018 3 2020
APB 5 Development: APB 5 IOC 4 2020 4 2020
APB 5+ Development: APB 5+-1 Developmental Test (DT) 3 2020 4 2020
APB 5+ Development: APB 5+ Operation Test (IT/OT) 4 2020 3 2021
APB 5+ Development: APB 5+ IOC 4 2021 4 2021
APB 6 Software / TI-1 Hardware Development: APB 6 Development 1 2018 2 2024
APB 6 Software / TI-1 Hardware Development: TI-1 Development 4 2019 4 2024
APB 6 Software / TI-1 Hardware Development: APB 6/TI-1 Developmental Test (DT) 3 2023 4 2024
APB7 / TI-2 Development: APB7 / TI-2 Prototype Testing and Demonstration 1 2021 1 2022
APB7 / TI-2 Development: APB7 / TI-2 Development: APB 7 Software Development
and Engineering Tests
1 2022 4 2025
APB7 / TI-2 Development: APB7 / TI-2 Development: TI-2 Hardware Development and
Engineering Tests
1 2022 4 2025
Volume 5 - 557
UNCLASSIFIED
THIS PAGE INTENTIONALLY LEFT BLANK
UNCLASSIFIED
Volume 5 - 558
